In project management, a Cost Breakdown Structure (CBS) is a vital view used to organize and track expenses throughout a project’s lifecycle. Breakdown structures like the CBS, Work Breakdown Structure (WBS), and Resource Breakdown Structure (RBS) help categorize complex project elements into manageable components, ensuring better cost control, forecasting, and financial transparency.
In this article, we’ll take a closer look at the CBS, how it works, its key components, its applicability in cost management, and the complexities involved in implementing it.
What is a Cost Breakdown Structure (CBS) in project management?

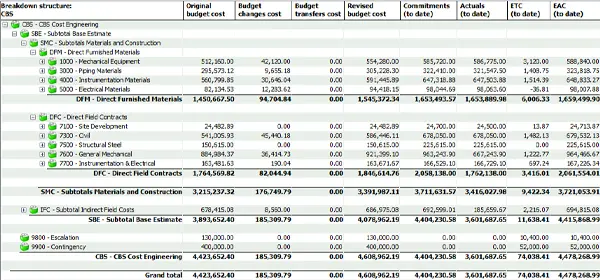

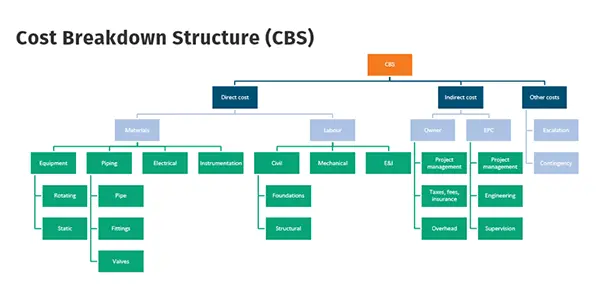

A Cost Breakdown Structure (CBS) is a hierarchical framework that categorizes and organizes all project cost items, from high-level budget sections to detailed labor activities, equipment costs, and material spendings. Similar to a Work Breakdown Structure (WBS), which focuses on deliverables, a CBS focuses on cost elements, providing a structured view of project expenses.
As the financial blueprint of a project, CBS ensures costs are systematically structured for budgeting, tracking, and forecasting. It aligns project costs with scope and objectives, offering a clear overview of spending. By using CBS, project managers can identify cost drivers, compare actual costs to estimates, and maintain financial control throughout the project lifecycle. By using a CBS together with a WBS (integrated with the schedule), you can even go for integrated cost and schedule overviews.
Components included in a CBS
A Cost Breakdown Structure (CBS) categorizes and organizes project costs into structured components, helping project managers track and control expenses at a granular level. Each cost category consists of specific cost items, which represent individual expenses that contribute to the total budget. A CBS typically includes:
1. Direct Costs: Expenses directly linked to project execution, such as:
- Labor Costs (e.g., wages, salaries, benefits)
- Material Costs (e.g., raw materials, supplies, freight, insurance)
- Equipment Costs (e.g., machinery, rentals, tools)
2. Indirect Costs: Overhead expenses that support the project but are not tied to a single task, including:
- Office space, utilities, administrative costs
- Site supervision and management expenses
3. Escalation Costs: While not always mentioned in cost breakdown structures, we like to add it as a separate section. Escalation is defined as the increase in cost due to inflationary and economic environment as measured from the cost estimate base date to the projected spend profile of the project.
4. Contingency Costs: Every estimating assumption carries a certain degree of risk. Contingency costs account for these uncertainties in project estimation. The amount of contingency depends on the level of risk and experience with similar projects. For example, in a new field of knowledge, the risk is greater, while in a routine project, the risk is smaller.
Why use a Cost Breakdown Structure (CBS)?
1. Better visibility and control over project costs
A Cost Breakdown Structure (CBS) offers clear insight into how funds are allocated, both within specific cost categories and at a broader summary level. This detailed breakdown simplifies cost monitoring and control throughout the project lifecycle. By adopting a proactive cost management approach, identifying areas for potential overruns early on becomes easier. This leaves room for adjustments, such as reallocating resources or renegotiating contracts, before costs actually escalate.
2. Improved cost estimation and forecasting
A CBS offers a structured historical reference for budgeting and forecasting. By leveraging data from similar past projects, teams can ensure that they are accounting for all potential cost types, reducing the risk of overlooking important expenses. Furthermore, by analyzing actual costs from previous budgets, teams can create more accurate cost estimates by using these historical learnings (e.g., compare percentage of mechanical scope estimates). This approach not only improves the quality of estimates but also enables more informed decisions from the start.
3. Allows for proactive risk and contingency management
Including a contingency section in the CBS enables project teams to allocate funds for potential risks such as material price increases, delays, or scope changes. Conducting regular CBS analysis at key project milestones also ensures that financial risks are identified early, allowing teams to address issues before they impact the project’s overall budget and timeline.
4. Insights into resource allocation
In a CBS, all resources are categorized into labor, materials, and equipment costs, making it easier to identify inefficiencies and strategically reallocate resources where needed. By providing a clear view of resource distribution, CBS helps reduce waste and supports more efficient procurement decisions, ensuring that resources are utilized effectively throughout the project.
5. Fosters transparency and accountability among stakeholders
The CBS improves transparency by breaking down the budget into specific categories, so stakeholders can clearly see where funds are allocated instead of looking at one large, unclear budget. This makes it easier for teams, clients, and investors to understand how money is being spent and ensures everyone stays aligned on budget expectations. At the same time, it provides clarity on who is responsible for different budget areas, making accountability more straightforward. If there’s any overspending or inefficiency, the CBS helps pinpoint the source of the issue quickly so corrective actions can be taken.
The complexity of setting up a Cost Breakdown Structure
Setting up a Cost Breakdown Structure (CBS) is not just about categorizing costs—it’s about making project costs more understandable by breaking them down into smaller, more manageable components. Rather than viewing costs as a single line item, a CBS allows project teams to analyze expenses at different levels of detail, providing clearer insights into specific areas of spending. However, this structured approach introduces several challenges.
Shifting breakdown structures dynamically
One key complexity is determining how to structure the breakdown in a way that makes sense for different stakeholders. For example, a financial controller may need to view costs by category (e.g., labor, materials, and equipment), while an area supervisor might prefer to see costs organized by project sections, such as different areas of a factory. Similarly, procurement teams may require a breakdown based on purchasing categories, while engineering teams may focus on process equipment or specialized components. The difficulty lies not only in defining the CBS but also in recognizing whether the CBS makes sense for the person in front of you. For the financial controller it makes sense to go with a CBS but for the supervisor another breakdown structure would be required (WBS or ABS).
Balancing detail with usability
Another challenge can be striking the right balance between creating a CBS that is comprehensive enough while remaining easy to manage. While a detailed CBS provides granular insights, excessive detail can quickly make it overwhelming to navigate and update. This is especially the case when managed in spreadsheets where having too many rows and columns can make it difficult to find and update the right information as well as increase the risk of mistakes. It’s essential to maintain a CBS that is detailed enough to capture all necessary cost elements, but it should remain user-friendly to facilitate effective decision-making.
Defining consistent cost categories
Lastly, defining cost categories for indirect expenses, escalation, and contingency can be tricky. Some expenses, such as shared overhead or costs that don’t neatly fit into one category, require careful judgment and standardized allocation methods. Ensuring that these definitions are consistent across various departments is crucial to prevent misinterpretation of financial data and maintain clarity in the overall cost structure.
What is the Cost Breakdown Analysis (CBA)?
The Cost Breakdown Analysis (CBA) is a detailed examination of a project’s Cost Breakdown Structure (CBS). While the CBS itself is a hierarchical framework that categorizes and organizes costs into structured components (such as labor, materials, and equipment), the cost breakdown analysis involves analyzing these costs to track their accuracy and identify variances, inefficiencies, and potential risks. In essence, the CBS provides the data, and CBA is the process of assessing that data for financial control.
How to conduct an analysis based on the CBS
When conducting a cost breakdown analysis, pay attention to the following aspects:
Compare Estimated vs. Actual Costs to identify overruns
Compare the estimated costs for each component of the CBS to the actual costs incurred to identify any areas where spending might have deviated from the initial budget. If there are significant variances, investigate the reasons behind them (e.g., scope changes, unforeseen issues, or inaccurate initial estimates), and take corrective actions.
Assess project risks and contingency allocation
Evaluate how well the contingency fund is being utilized. If you have faced any unforeseen costs or risks, assess whether the allocated contingency funds are sufficient to cover them. If the contingency is running low, you may need to reallocate funds or find other ways to mitigate further financial risk.
Monitor scope changes
Scope changes are a common source of cost deviation. Thus, review any changes in the project scope (e.g., added tasks, deliverables, or alterations to existing work) and assess their impact on the budget and timeline. If the scope expands, additional resources or funds may be necessary. Use your CBA to evaluate the financial impact of these changes and ensure they remain aligned with the overall project budget.
Review key milestones and project phases
Regularly conduct a cost breakdown analysis at key project milestones or phases. It is important to monitor how costs are accumulating over time and whether any particular phase is exceeding its budget. Identifying issues early on allows for corrective measures to be taken before the project progresses too far.
How Cleopatra helps with CBS and overall cost tracking
With a versatile project controls tool like Cleopatra Enterprise, you can overcome many of the challenges associated with managing breakdown structures (e.g., CBS, WBS, ABS, OBS). Whether you need to view costs by category, project area, or purchasing details, Cleopatra allows you to switch between different breakdown views at the click of a button. This flexibility means that whether you’re a financial controller, an area supervisor, or a member of the procurement team, you can drill down into the details or pull back for a higher-level overview exactly when you need it.
Additionally, Cleopatra provides:
- Real-time cost updates, variance analysis, and proactive alerts to flag potential budget overruns before they escalate.
- Interactive dashboards, drill-down cost analysis, and S-curves for visualizing project costs dynamically.
- Earned Value Management (EVM) metrics (e.g., CPI and SPI) to monitor project health and support better forecasting.
By leveraging these capabilities, Cleopatra enables informed project throughout the project lifecycle.
Effective project planning lays the groundwork for success yet challenges often arise beyond the initial blueprint. Among these…
Managing a project and keeping it under “control” can be an extremely challenging process. That’s where project controls…
FAQs
-
What is the difference between CBS and WBS?
A Work Breakdown Structure (WBS) focuses on project deliverables by breaking down the scope into smaller, manageable tasks to ensure proper execution and scheduling. On the other hand, a Cost Breakdown Structure (CBS) focuses on cost elements, providing a structured view of project expenses.
While the WBS outlines the “work to be done”, the CBS assigns costs to each part of that work, allowing for a clear link between project scope and financial planning.
-
What is the difference between CBS vs RBS?
A Cost Breakdown Structure (CBS) categorizes project costs, such as labor, materials, and equipment, to manage budgets, track spending, and support cost forecasting. In contrast, a Resource Breakdown Structure (RBS) classifies resources like personnel, equipment, and materials based on their type and function within the project.
While the CBS focuses on financial planning, the RBS ensures efficient resource allocation. Together, they help align cost management with resource utilization for better project execution.
Related resources

Work Breakdown Structures (WBS): the correct philosophy
Dig into the Work Breakdown Structures for assigning the work-packages / deliverables and apply the correct cost control philosophy.
Read blog article
Defining and Creating Resource Breakdown Structures (RBS)
In this blog, we look at Resource Breakdown Structures, how to create them, their benefits, and practical tips for implementation.
Read blog article
